Best Practices in Offshore Lifting Operations: A Comprehensive Guide
Back to Blog
Operations

Best Practices in Offshore Lifting Operations: A Comprehensive Guide

March 9, 2026 10 min readFelipe LescureBy Felipe Lescure, CEO β€” RIGGING TECH

Every offshore lifting operation is a high-consequence event. The combination of heavy loads, dynamic marine environments, and limited emergency access means that best practices are not aspirational guidelines β€” they are the minimum standard for protecting lives, assets, and the environment. This guide consolidates the essential practices that experienced rigging professionals apply before, during, and after every lift.

1. Pre-Lift Planning: The Foundation of Every Safe Lift

The most critical phase of any offshore lifting operation occurs before the crane hook is ever engaged. Pre-lift planning establishes the engineering basis for the entire operation and must address load characteristics, crane capacity, rigging configuration, environmental constraints, and personnel competency. A well-executed planning phase eliminates the majority of risks before they can materialize on deck.

The planning process begins with a thorough load assessment. This includes determining the verified weight of the load (never relying on estimates), locating the center of gravity through engineering calculation or physical testing, and identifying any structural vulnerabilities that could affect the load's integrity during the lift. For offshore operations, the load assessment must also account for dynamic amplification factors (DAF) caused by vessel motion β€” a factor that can increase effective loads by 20-40% depending on sea state conditions.

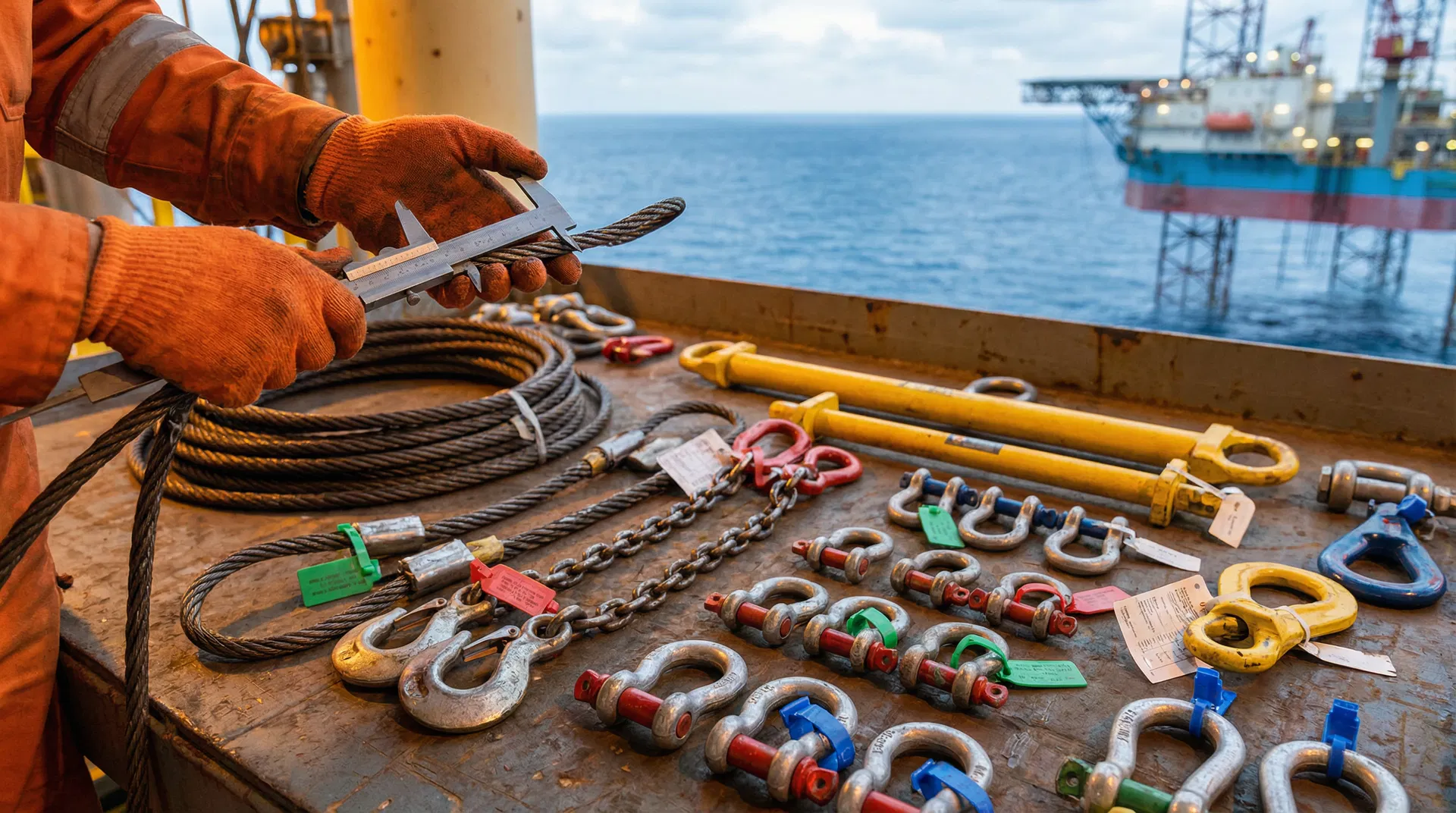

Pre-lift inspection of rigging equipment on offshore deck

Pre-lift inspection of rigging equipment β€” every component must be verified before operations begin.

2. Crane Selection and Capacity Verification

Selecting the appropriate crane for an offshore lift requires more than simply matching the load weight to the crane's rated capacity. The crane's load chart must be analyzed at the specific boom length, radius, and configuration required for the planned lift. For offshore pedestal cranes, this analysis must incorporate the vessel's motion characteristics, including heave compensation capabilities and the operational limits defined by the crane manufacturer.

Industry best practice mandates that the total rigged weight β€” including the load, all rigging hardware, and any below-the-hook devices β€” should not exceed 80% of the crane's rated capacity at the planned radius. For critical lifts, this threshold is typically reduced to 75% or lower, depending on the operator's management system and the applicable regulatory framework (DNV-ST-N001, LOLER, or client-specific standards).

Lift CategoryMax Capacity UsagePlanning Requirements
Routine Lift≀ 80% rated capacityStandard lift plan, toolbox talk
Engineered Lift≀ 80% rated capacityEngineered lift plan with calculations
Critical Lift≀ 75% rated capacityFull engineering study, management approval
Heavy LiftPer crane OEM limitsSpecialist engineering, third-party verification

3. Rigging Hardware Selection and Inspection

The selection of rigging hardware β€” slings, shackles, hooks, spreader beams, and lifting frames β€” must be based on engineering calculations that account for sling angles, dynamic loading, and appropriate safety factors. For offshore applications, a minimum safety factor of 4:1 is standard for slings, while shackles and other hardware typically require 5:1 or 6:1 depending on the applicable standard.

Every piece of rigging hardware must be inspected before use. This inspection is not a formality β€” it is a critical safety barrier. Wire rope slings must be checked for broken wires, corrosion, kinking, and diameter reduction. Chain slings require examination for elongation, wear at bearing points, and cracks. Shackles must be verified for correct pin engagement and absence of deformation. Any equipment that fails inspection must be immediately quarantined and removed from service.

"The best rigging plan in the world is worthless if executed with defective equipment. Inspection is not bureaucracy β€” it is the last line of defense before a load goes airborne."
β€” Felipe Lescure, CEO β€” RIGGING TECH

4. Environmental Assessment and Operational Limits

Offshore lifting operations are uniquely affected by environmental conditions. Wind speed, wave height (significant wave height, Hs), current, and vessel motion all influence the safety and feasibility of a lift. Every lifting operation must have clearly defined environmental limits β€” the maximum conditions under which the operation is authorized to proceed.

These limits are not arbitrary. They are derived from the crane manufacturer's operational specifications, the vessel's motion response characteristics, and the engineering analysis of the specific lift. Common thresholds include maximum wind speeds of 15-20 m/s for routine lifts and Hs limits of 1.5-2.5 meters, though these vary significantly based on the crane type, load characteristics, and operational context. The Lifting Supervisor has the authority β€” and the responsibility β€” to halt operations when conditions approach or exceed these limits.

5. Communication and Team Coordination

Clear, unambiguous communication is essential during every phase of a lifting operation. The minimum team for an offshore lift typically includes a Lifting Supervisor, crane operator, banksman/signalman, and riggers. Each role has defined responsibilities, and the communication protocol β€” whether using hand signals, radio, or a combination β€” must be established and confirmed during the pre-lift toolbox talk.

The toolbox talk itself is a critical best practice. It is not a checkbox exercise but a structured briefing where the lift plan is reviewed, roles are confirmed, hazards are discussed, and every team member has the opportunity to raise concerns. The principle of "Stop Work Authority" must be reinforced: any team member, regardless of rank, has the right and obligation to stop the operation if they observe an unsafe condition.

6. Execution: Controlled Lifting Procedures

During execution, the lift must follow the approved plan precisely. The sequence typically begins with a trial lift β€” raising the load just clear of its supports (typically 150-300mm) to verify the rigging configuration, confirm the center of gravity, and check for any unexpected behavior. The load is held at this height while the Lifting Supervisor confirms that all parameters are within acceptable limits.

Once the trial lift is satisfactory, the main lift proceeds with controlled, smooth crane movements. Tag lines are used to control load rotation and swing, with riggers positioned outside the load's potential fall zone at all times. The crane operator maintains constant communication with the banksman and follows only authorized signals. No personnel are permitted under a suspended load under any circumstances.

7. Post-Lift Review and Continuous Improvement

Best practice extends beyond the completion of the lift. A post-lift review should capture lessons learned, identify any deviations from the plan, and document any near-misses or observations that could improve future operations. This feedback loop is essential for continuous improvement and is a hallmark of mature safety management systems.

Digital platforms such as RIGGING TECH's PILO\u2122 system facilitate this process by automatically logging operational data, capturing real-time equipment status, and generating performance analytics that enable data-driven improvements across the fleet.

Conclusion

Best practices in offshore lifting operations are not static rules β€” they are a dynamic framework that integrates engineering discipline, equipment integrity, human competency, and environmental awareness. Every lift is unique, and the application of these practices must be tailored to the specific conditions, equipment, and personnel involved. The organizations that consistently achieve zero-incident lifting records are those that treat every lift as a critical operation, regardless of its apparent simplicity.
